Hi Bunuel,
I didn't get the 2nd part. How did you calculated 20 months?

Bunuel
I have revised the question, solution, and formatting by adding more details to enhance clarity
User avatar
Bunuel
User avatar
Math Expert
Joined: 02 Sep 2009
Last visit: 21 Apr 2026
Posts: 109,724
Own Kudos:
Given Kudos: 105,797
Products:
Expert
Expert reply
Active GMAT Club Expert! Tag them with @ followed by their username for a faster response.
Posts: 109,724
Kudos: 810,387
Kudos
Add Kudos
Bookmarks
Bookmark this Post
Hitesh0701
Hi Bunuel,
I didn't get the 2nd part. How did you calculated 20 months?

Bunuel
I have revised the question, solution, and formatting by adding more details to enhance clarity

Look at event 2 on the graph. The jump upward from event 1 to event 2 goes from about 38 months to about 58 months. The difference is about 20 months, which is the size of the delay. That is how the 20 months was calculated.
User avatar
Gg153
Joined: 25 Oct 2024
Last visit: 02 Feb 2026
Posts: 99
Own Kudos:
Given Kudos: 102
Location: India
Products:
Posts: 99
Kudos: 52
Kudos
Add Kudos
Bookmarks
Bookmark this Post
I didnt understand the first part, weren't there three delays according to the given information?
User avatar
Bunuel
User avatar
Math Expert
Joined: 02 Sep 2009
Last visit: 21 Apr 2026
Posts: 109,724
Own Kudos:
810,387
 [3]
Given Kudos: 105,797
Products:
Expert
Expert reply
Active GMAT Club Expert! Tag them with @ followed by their username for a faster response.
Posts: 109,724
Kudos: 810,387
 [3]
3
Kudos
Add Kudos
Bookmarks
Bookmark this Post
sanya511
I didnt understand the first part, weren't there three delays according to the given information?

The x-axis shows time, and the y-axis shows months remaining until launch. As time moves forward, the line goes down if the launch is getting closer. An upward jump means the launch was pushed further out, increasing the months remaining. That indicates a delay. There are 9 such jumps, so 9 delays.

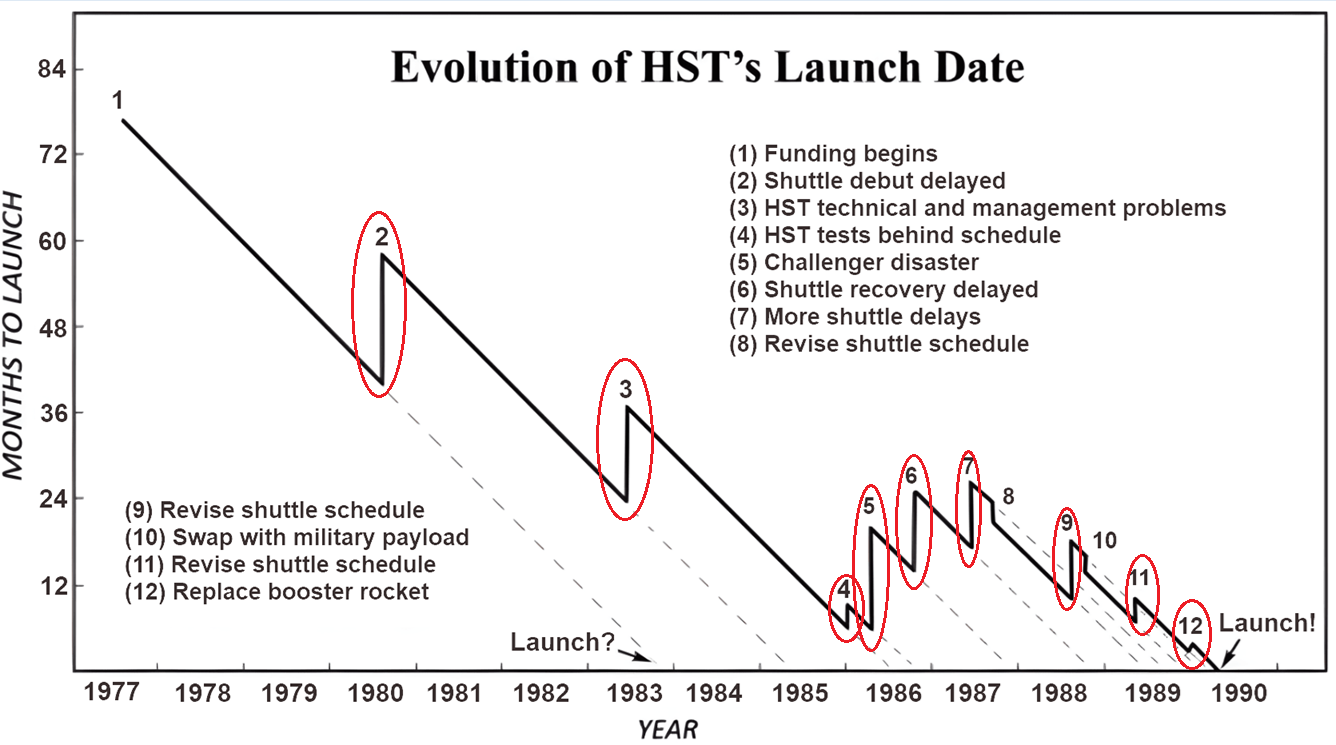

Attachment:
GMAT-Club-Forum-d0px3usk.png [ 260.95 KiB | Viewed 2766 times ]
User avatar
canadianmonkey3
Joined: 28 Jun 2023
Last visit: 13 Apr 2026
Posts: 11
Own Kudos:
Given Kudos: 74
Location: Canada
GMAT Focus 1: 645 Q86 V84 DI74
GMAT Focus 2: 655 Q84 V82 DI82
GMAT 1: 530 Q35 V27
GPA: 2.7
Products:
Kudos
Add Kudos
Bookmarks
Bookmark this Post
I approached this question by focusing on the term "Hubble Space Telescope???s production schedule." Based on that wording, I interpreted the question as referring specifically to the development and readiness of the Hubble itself and not the external factors related to the Space Shuttle program. Since the shuttle and the HST are separate entities (a launch vehicle versus a scientific payload), I only considered events directly related to the telescope???s technical development (e.g., testing, engineering, and management issues) as relevant sub-events, i.e, events 2 and 3.

However, the correct answer appears to include all launch delays, even those due to unrelated shuttle issues such as the Challenger disaster or military payload swaps. If the intent was to include all launch-affecting events, regardless of whether they were internal to HST???s production, then the question could have been worded more clearly to reflect that broader scope.

Please let me know if my interpretation and explanation is unreasonable/incorrect based on the phrasing provided. Thank you!
User avatar
Bunuel
User avatar
Math Expert
Joined: 02 Sep 2009
Last visit: 21 Apr 2026
Posts: 109,724
Own Kudos:
810,387
 [1]
Given Kudos: 105,797
Products:
Expert
Expert reply
Active GMAT Club Expert! Tag them with @ followed by their username for a faster response.
Posts: 109,724
Kudos: 810,387
 [1]
1
Kudos
Add Kudos
Bookmarks
Bookmark this Post
canadianmonkey3
I approached this question by focusing on the term "Hubble Space Telescope???s production schedule." Based on that wording, I interpreted the question as referring specifically to the development and readiness of the Hubble itself and not the external factors related to the Space Shuttle program. Since the shuttle and the HST are separate entities (a launch vehicle versus a scientific payload), I only considered events directly related to the telescope???s technical development (e.g., testing, engineering, and management issues) as relevant sub-events, i.e, events 2 and 3.

However, the correct answer appears to include all launch delays, even those due to unrelated shuttle issues such as the Challenger disaster or military payload swaps. If the intent was to include all launch-affecting events, regardless of whether they were internal to HST???s production, then the question could have been worded more clearly to reflect that broader scope.

Please let me know if my interpretation and explanation is unreasonable/incorrect based on the phrasing provided. Thank you!
All events shown in the graph are part of the Hubble launch timeline, whether caused by the telescope or external factors like the shuttle. Overcomplicating it by filtering events misses what the question is asking. Just count all delays shown.
User avatar
BinodBhai
Joined: 19 Feb 2025
Last visit: 15 Oct 2025
Posts: 107
Own Kudos:
31
 [1]
Given Kudos: 252
Posts: 107
Kudos: 31
 [1]
1
Kudos
Add Kudos
Bookmarks
Bookmark this Post
I don’t quite agree with the solution. The 2nd delay starts from mid-1980 to mid-1983; how come it's 20 months?
User avatar
Bunuel
User avatar
Math Expert
Joined: 02 Sep 2009
Last visit: 21 Apr 2026
Posts: 109,724
Own Kudos:
Given Kudos: 105,797
Products:
Expert
Expert reply
Active GMAT Club Expert! Tag them with @ followed by their username for a faster response.
Posts: 109,724
Kudos: 810,387
Kudos
Add Kudos
Bookmarks
Bookmark this Post
BinodBhai
I don’t quite agree with the solution. The 2nd delay starts from mid-1980 to mid-1983; how come it's 20 months?

The “20 months” comes from the vertical jump at event 2: the schedule moved from about 36 to 56 months to launch. The 1980–1983 stretch is just the revised countdown ticking down, not the delay itself.
User avatar
Vishnu0001
Joined: 03 Jun 2024
Last visit: 18 Apr 2026
Posts: 19
Own Kudos:
4
 [1]
Given Kudos: 8
Products:
Posts: 19
Kudos: 4
 [1]
1
Kudos
Add Kudos
Bookmarks
Bookmark this Post
Bunuel

All events shown in the graph are part of the Hubble launch timeline, whether caused by the telescope or external factors like the shuttle. Overcomplicating it by filtering events misses what the question is asking. Just count all delays shown.
Hi, I think it is better to revise the question wording to better reflect what is being asked. "Delays during the Production schedule of the HST" is what is being asked. And as per your graph, the production schedule finishes by 3 or 4 (if by "production" you mean the whole development phase). Official GMAT questions don't introduce such ambiguity.
User avatar
Bunuel
User avatar
Math Expert
Joined: 02 Sep 2009
Last visit: 21 Apr 2026
Posts: 109,724
Own Kudos:
Given Kudos: 105,797
Products:
Expert
Expert reply
Active GMAT Club Expert! Tag them with @ followed by their username for a faster response.
Posts: 109,724
Kudos: 810,387
Kudos
Add Kudos
Bookmarks
Bookmark this Post
Vishnu0001

Hi, I think it is better to revise the question wording to better reflect what is being asked. "Delays during the Production schedule of the HST" is what is being asked. And as per your graph, the production schedule finishes by 3 or 4 (if by "production" you mean the whole development phase). Official GMAT questions don't introduce such ambiguity.

Fixed the issue. Thank you!
