1. total weeks 14

Development team atleast one task from start of 7th week till 14th week
8 /14% = 57.14= 55~

D

2.) at the begin of 8th week, marketing team , planning team and development team have some task to start

C
User avatar
yashikaaggarwal
User avatar
Senior Moderator - Masters Forum
Joined: 19 Jan 2020
Last visit: 17 Jul 2025
Posts: 3,086
Own Kudos:
3,102
 [1]
Given Kudos: 1,510
Location: India
GPA: 4
WE:Analyst (Internet and New Media)
Posts: 3,086
Kudos: 3,102
 [1]
Kudos
Add Kudos
1
Bookmarks
Bookmark this Post
Development Team started it's time-and-task schedule as per the following order:

Week 7-8 Detail Design
Week 8-12 Development
Week 11-12 Test Plan
Week 12-14 Testing and QA
Week 13-14. User Document

Out of which week 8,11,12,13,14 are having two or more task.

1) The number of weeks the development team has at least one task scheduled is 7,8,9,10,11,12,13,14 = 8 weeks
The percentage of 8 working weeks of development team to total working weeks of whole marketing team = (8/14)*100
=> 57.14 or 55%(to the nearest)
Answer is D

The time and task schedule of marketing team is as follow :
1) Market Research week : 1-2 & week 8-9
2) Define Specification : week 3-4
3) Overall Architect : week 5-6
4) Project Planning : week 6-7
5) Detail Design : week 7-8
6) Development : week 8-12
7) Test Plan : week 8-9 & week 11-12
8) Testing and QA : week 12-14
9) User Documentation : week 10-11 & 13-14

2) Out of these; Test plan, Development and market research is been starting in the same week 8
Answer is C

Posted from my mobile device
User avatar
Rohi02
Joined: 05 Aug 2019
Last visit: 05 Dec 2022
Posts: 20
Own Kudos:
Given Kudos: 8
Posts: 20
Kudos: 6
Kudos
Add Kudos
Bookmarks
Bookmark this Post
1. Ans- D. Number of weeks from which developement team has started working till the completion of development work = 8
Total weeks for project completion = 14
Required %= (8/14)*100 = 57.14% which is close to 55% .

2. Ans- C. 8th week is the only week where one task from each team are scheduled to begin.
User avatar
blackhawk7
Joined: 07 Feb 2021
Last visit: 28 Aug 2025
Posts: 28
Own Kudos:
Given Kudos: 117
Posts: 28
Kudos: 24
Kudos
Add Kudos
Bookmarks
Bookmark this Post
Had the answer for RO1 been 57.8, would the rounding to the nearest 5% be 60? Not sure of how rounding by percentage works.
User avatar
Garima240193
Joined: 05 Jul 2022
Last visit: 03 Jun 2024
Posts: 1
Given Kudos: 22
Posts: 1
Kudos: 0
Kudos
Add Kudos
Bookmarks
Bookmark this Post
Can we expect this level of questions in EA IR? or are they much difficult? I solved some papers and IR was really tough..
User avatar
Sajjad1994
User avatar
GRE Forum Moderator
Joined: 02 Nov 2016
Last visit: 18 Nov 2025
Posts: 17,289
Own Kudos:
Given Kudos: 6,179
GPA: 3.62
Products:
Posts: 17,289
Kudos: 49,291
Kudos
Add Kudos
Bookmarks
Bookmark this Post
Garima240193
Can we expect this level of questions in EA IR? or are they much difficult? I solved some papers and IR was really tough..

Hello Garima240193

Definitely one can expect such a question in the real GMAT/EA test as this question belongs to the official GMAT/EA source.

Best
User avatar
anshikag22
Joined: 16 Aug 2024
Last visit: 25 Nov 2024
Posts: 14
Own Kudos:
Given Kudos: 277
Posts: 14
Kudos: 6
Kudos
Add Kudos
Bookmarks
Bookmark this Post
does rounding off to the nearest 5% mean rounding down? Experts pls clarify
KarishmaB chetan2u
User avatar
KarishmaB
Joined: 16 Oct 2010
Last visit: 18 Nov 2025
Posts: 16,265
Own Kudos:
76,982
 [4]
Given Kudos: 482
Location: Pune, India
Expert
Expert reply
Active GMAT Club Expert! Tag them with @ followed by their username for a faster response.
Posts: 16,265
Kudos: 76,982
 [4]
3
Kudos
Add Kudos
1
Bookmarks
Bookmark this Post
Quote:
Attachment:

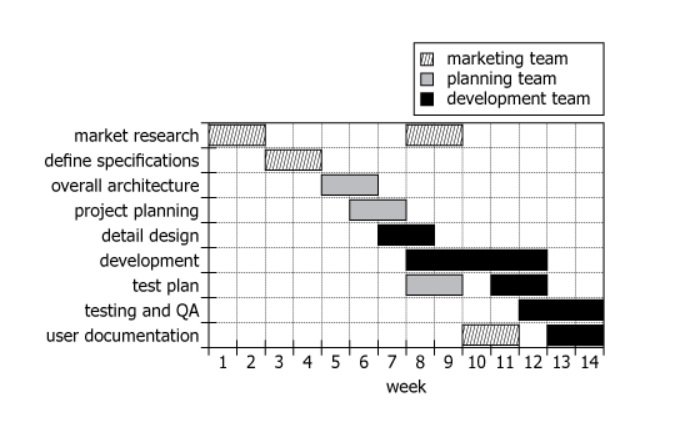

The chart shows a firm’s complete time-and-task schedule for the marketing team, planning team, and development team involved in the launching of a new product.

Based on the information in the graph, select from each drop-down menu the option that creates the most accurate statement.

1. To the nearest 5 percent, the number of weeks the development team has at least one task scheduled is percent of the total duration represented by the chart.

2. Week is the only week during which three different tasks are scheduled to begin.
-



1. To the nearest 5 percent, the number of weeks the development team has at least one task scheduled is ___ percent of the total duration represented by the chart.

The black bars of the development team exist in all weeks from 7 to 14 which is 8 weeks. There are total 14 weeks in the timeline.
So the dev team has tasks scheduled in 8/14th of the duration.

In percentage terms, use a calculator to get the exact value 8/14 = 57.12%
or recall that 8/14 = 4/7 and 1/7 is simply 14.28%.
So 4/7 is 4 * 14.28 which is very slightly more than 57% (because 4 times 14 is 56 and 4 times 28 is just above 100)

When we round it to the nearest 5%, it means we round it to either 50% or 55% or 60% or 65% etc whichever is closest. We may round it up or round it down. The point is that it must be the closest value.
57.12 is closer to 55 than to 60. 57.5 is in the middle. anshikag22
Hence 55% is the answer.


2. Week ___ is the only week during which three different tasks are scheduled to begin.

3 bars begin at the beginning of week 8.

Select 8

Here is a video discussing graphs: https://youtu.be/ilMxPjHNeic

Here are some posts on rounding:
https://anaprep.com/number-properties-r ... -decimals/
https://anaprep.com/number-properties-o ... -rounding/
https://anaprep.com/number-properties-q ... -decimals/
