The fraction of the work done by Alex, Beth, Charles & Dana in an hour is 1/8, 1/20, 1/40 & 1/80 respectively.
For minimum number of hours, we assign the work to most productive workers first.
Hour 1: Alex : Work done = 1/8 = 12.5%
Hour 2: Beth : Work done = 1/20 = 5% : Cumulative work done = 1/8 + 1/20 = 17.5%
Hour 3: Charles: Work done = 1/40 = 2.5%: Cumulative work done = 17.5% + 2.5% = 20%
Hour 4: Dana: Work done = 1/80 = 1.25%: Cumulative work done = 21.25%
Hours 5-8: Cumulative work done = 21.25% + 21.25% = 42.5%
Hours 9-12: Cumulative work done = 42.5% + 21.25% = 63.75%
Hours 13-16: Cumulative work done = 63.75% + 21.25% = 85%
Hour 17: Alex : Work done = 1/8 = 12.5% : Cumulative work done = 85% + 12.5% = 97.5%
Remaining work = 100% - 97.5% = 2.5%
Beth can do the remaining work in 2.5%/5% = .5 hours

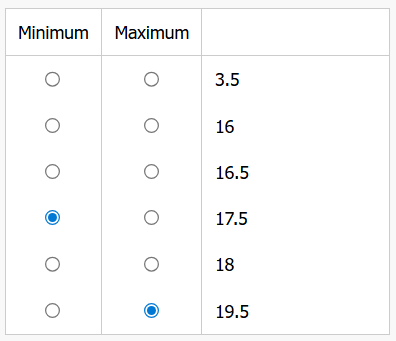

Minimum hours required for the task to be completed = 17.5 hours
For maximum number of hours, we assign the work to the least productive workers first.
Hours 1-4: Cumulative work done = 21.25%
Hours 5-8: Cumulative work done = 42.5%
Hours 9-12: Cumulative work done = 63.75%
Hours 13-16: Cumulative work done = 85%
Hour 17: Dana: Work done = 1/80 = 1.25%: Cumulative work done = 85% + 1.25% = 86.25%
Hour 18: Charles: Work done = 1/40 = 2.5%: Cumulative work done = 86.25% + 2.5% = 88.75%
Hour 19: Beth : Work done = 1/20 = 5%: Cumulative work done = 88.75% +5% = 93.75%
Remaining work = 100% - 93.75% = 6.25%
Time taken by Alex to complete the task = 6.25%/12.5% = .5 Hours
Maximum number of hours to complete the task = 19.5 hours
